UAE Company Formation Timeline: From Application to Launch


Table of Contents
About the Author
The author is a UAE-based business setup and compliance advisor with over a decade of experience supporting startups, SMEs, and international investors across mainland and free zone jurisdictions. The author has worked closely with licensing authorities, immigration departments, and banks across the UAE, advising businesses on formation, restructuring, and operational readiness.
Key Takeaway:
- Most delays in the UAE company formation timeline originate at the planning stage, not during approvals. Choosing an unsuitable jurisdiction, license type, or business activity early on often leads to avoidable amendments, extended visa processing, and longer banking timelines later.
- License issuance is only one milestone, not the finish line. While company licenses can be issued within days, full operational readiness, including visas, banking, and post-setup formalities, typically takes 4 to 8 weeks and should be planned accordingly.
- A structure aligned with how the business will actually operate is the biggest time-saver. Clear activity selection, simple ownership structures, and early preparation for banking and visas significantly shorten the overall UAE company formation process timeline and reduce long-term compliance issues.
What a Decade of Company Formation in the UAE has Taught Us About “Fast” Company Setups
“How long will it take?”
That’s almost always the first question we’re asked, and after years of advising startups, SMEs, and international investors in the UAE, we understand why.
Timelines affect budgets, relocation plans, hiring, and cash flow. Yet most information online either promises unrealistic speed or scares people with unnecessary complexity.
The truth is simpler and more reassuring: the UAE is one of the fastest places in the world to start a business, but only if the process is handled correctly from day one.
In fact, according to World Bank data, the average business setup timeline in high-income countries is around 10 days. In contrast, the UAE can offer significantly faster incorporation, ranging from as little as 15 minutes through the government’s Basher portal to approximately four working days when processed via the Department of Economic Development (DED).
In this guide, we’ll walk you through the UAE company formation process timeline, step by step, based on how it actually works in practice, not theory. We’ll also share examples of where things move quickly, where delays usually happen, and what experienced advisors do differently.
This article is written for founders, investors, and professionals who want clear expectations, not a sales pitch.
Step 1: Pre-Application Planning (1–3 Days)
This is the most underestimated stage of the entire process. Before any forms are submitted, three decisions shape the entire timeline:
- The exact business activity
- The jurisdiction (mainland or free zone)
- Whether visas and banking are needed immediately
In our experience, most delays start here, not at the authority level.
What often goes wrong
We’ve seen clients pick jurisdictions purely based on cost, only to realise later that their activity wasn’t permitted or accepted by banks. Fixing that means restarting approvals, losing both time and fees.
What works better
When activity, ownership structure, and future plans are aligned early, this stage takes one to three working days and sets up a smooth journey.
This is the foundation of the UAE company formation process timeline, even though nothing has officially started yet.
Step 2: Trade Name Approval and Initial Clearance (1–3 Working Days)
Once planning is complete, the first formal step begins by securing approval for the company name and business activity. This stage is generally quick, but not automatic.
Expert insight
Names that sound acceptable internationally are often rejected locally due to language, cultural references, or restricted wording. Over the years, we’ve learned that having backup names that follow authority preferences avoids unnecessary back-and-forth.
Approvals typically come through within one to three working days, sometimes faster in certain free zones.
At this stage, clients usually feel momentum, and rightly so, but this is still an early part of the wider UAE company formation process timeline.
Step 3: Legal Structure and Documentation (2–5 Working Days)
This is where timelines begin to vary. The more complex the ownership structure, the more care this stage requires.
What this stage includes
- Ownership documentation
- Authority-specific application forms
- Alignment of shareholder details
If all shareholders are UAE-based and documents are clean, this can be completed in two working days. However, overseas shareholders or corporate owners often introduce delays, not because of the UAE authorities, but because documents are signed abroad, notarised incorrectly, or submitted in the wrong format.
Based on our experience, documentation issues account for at least 40% of timeline extensions we’ve seen over the years. Handled correctly, this step moves quietly and efficiently.
Step 4: License Issuance and Company Setup (3–7 Working Days)
This is the milestone most founders look forward to when the business becomes legally recognized. Once documentation is approved and fees are cleared, the authority issues the business license.
What affects speed here
- Mainland business setups involve additional coordination with economic departments
- Free zone setups often move faster due to internal approvals
In real terms:
- Free zone companies: 3 to 5 working days
- Mainland companies: 5 to 7 working days
By this point, the business exists legally, but it’s not yet operational. This distinction is important and often misunderstood when discussing the UAE company formation process timeline.
Step 5: Visas and Identity Formalities (7–20 Working Days)
If the business requires visas for owners or staff, this stage runs parallel to operations planning.
What this includes
- Immigration file creation
- Medical testing
- Identity biometrics
- Emirates ID issuance
In straightforward cases, an investor visa dubai can be completed in around 10 to 14 working days. Multiple visas or scheduling delays can extend this.
Where delays usually happen
From what we’ve seen, delays rarely come from the system itself. They happen when appointments are postponed, medical tests are delayed, or documents are resubmitted unnecessarily.
Good coordination keeps this stage predictable.
Step 6: Corporate Bank Account Opening (2–6 Weeks)
This is the stage where expectations must be realistic. Banking in the UAE is heavily compliance-driven. Even simple businesses go through detailed checks.
Why does this take time
- Source of funds review
- Ownership verification
- Business model assessment
- Country risk review
A common misconception is that bank accounts open alongside licensing. In reality, banking often becomes the longest part of the UAE company formation process timeline.
Expert experience
A consulting firm with two partners, one local, one overseas, completed licensing in 9 working days. Banking, however, took 5 weeks due to the delayed submission of notarized shareholder documents. Once corrected, approval came without further questions.
Preparation here saves weeks.
Step 7: Post-Setup Formalities and Business Readiness (5–10 Days)
The final stage focuses on long-term stability.
What this includes
- Tax file creation (where applicable)
- Accounting system setup
- Office lease formalities (for mainland entities)
Based on our experience, businesses that skip or rush this stage often face compliance issues within their first year.
Within one working week, most companies are fully ready to trade, invoice, and grow.
What the Full Timeline Looks Like in Practice
Based on real cases across industries, here’s what most founders should expect:
- License issuance only: 7 to 14 working days
- License + visas: 3 to 4 weeks
- Full operational readiness, including banking: 4 to 8 weeks
Anything faster is possible, but never guaranteed. Longer timelines usually indicate planning gaps, not system failure.
Understanding the UAE company formation process timeline allows founders to plan launches sensibly instead of chasing unrealistic deadlines.

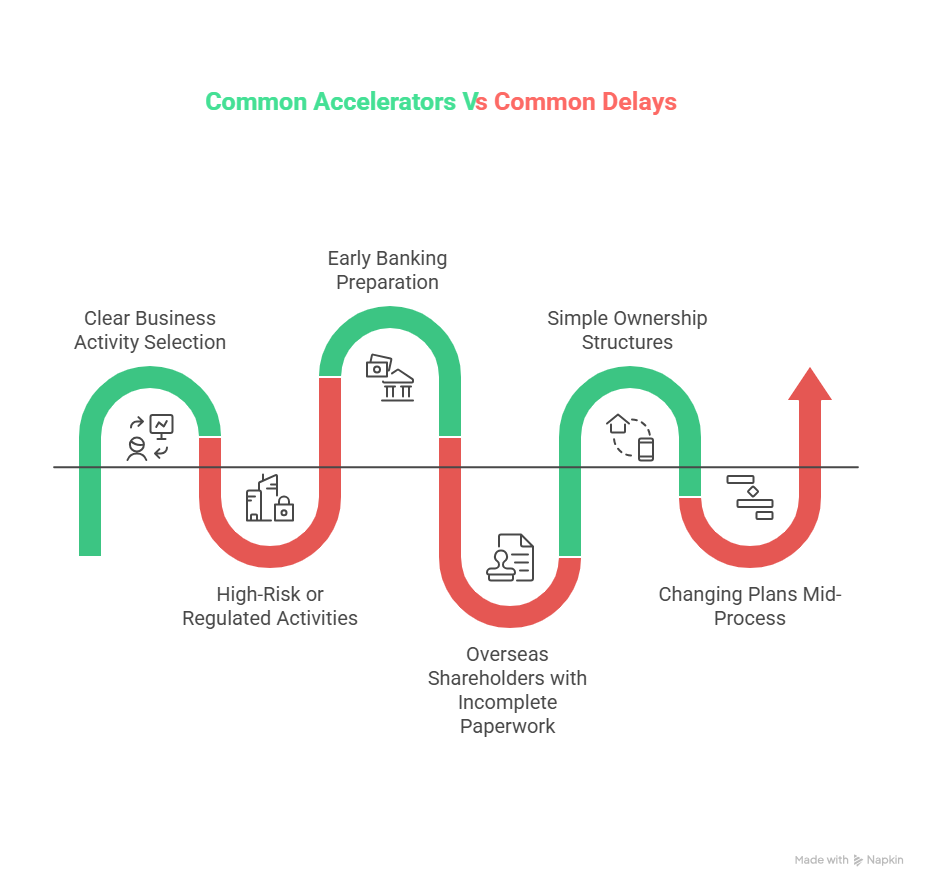

What Speeds Things Up—and What Slows Them Down
After a decade in this space, one thing is clear: most delays are preventable.

UAE Company Formation Timeline with RadiantBiz
At RadiantBiz, we have observed delays in the UAE company formation timeline not at the point of license issuance, but much earlier, when businesses select a jurisdiction or license type that does not accurately reflect how they plan to operate.
These early decisions often introduce structural constraints that later slow down visa processing, extend banking timelines, or require corrective amendments, pushing back the overall launch date.
When advising clients on the most suitable setup, our process begins with a focused assessment. Our business setup consultants take the time to understand the business model, long-term objectives, expected visa requirements, operational footprint, and target market before recommending any license type or jurisdiction.
This approach ensures that the selected structure supports a realistic and efficient company formation timeline, rather than just achieving initial approval.
If a free zone structure is the right fit, we avoid standardised recommendations. Dubai has multiple free zones, each with its own approved activities, authority processes, visa frameworks, and operational limitations. We assess which free zone genuinely aligns with the client’s activity and projected growth, rather than applying a generic solution that could introduce avoidable delays into the UAE company formation timeline in 2026.
Once the jurisdiction is defined, the client is supported by a dedicated specialist business setup consultant who reviews the approved business activities within that jurisdiction and aligns them precisely with the client’s actual operational requirements.
That specialist then works closely with the client to confirm the correct business activity, license category, and jurisdiction-appropriate structure, coordinating directly with the relevant authorities to ensure approvals move forward without disruption.
The objective is to establish a company setup that remains compliant, scalable, and timeline-efficient over the long term, so the business does not face unnecessary delays, restructuring, or interruptions to its UAE company formation timeline due to early-stage decision mismatches.
FAQs
1. How long does the UAE company formation process usually take?
Most businesses reach full operational readiness within 4 to 8 weeks, depending on visas and banking requirements.
2. What is the fastest way to start a company in the UAE?
Certain free zones issue licenses quickly, but overall readiness still depends on identity formalities and bank approvals.
3. Can I operate immediately after receiving the license?
Legally, yes, but practically, most businesses need banking and visas in place to operate fully.
The Timeline isn’t the Problem—Planning is
The UAE does not make business setup difficult. It makes it structured. When founders respect that structure and plan properly, the process moves smoothly and predictably. Trying to rush decisions or skip steps usually has the opposite effect.
If there’s one takeaway from my experience, it’s this: A well-managed UAE company formation process timeline saves time, money, and stress in the long run.
